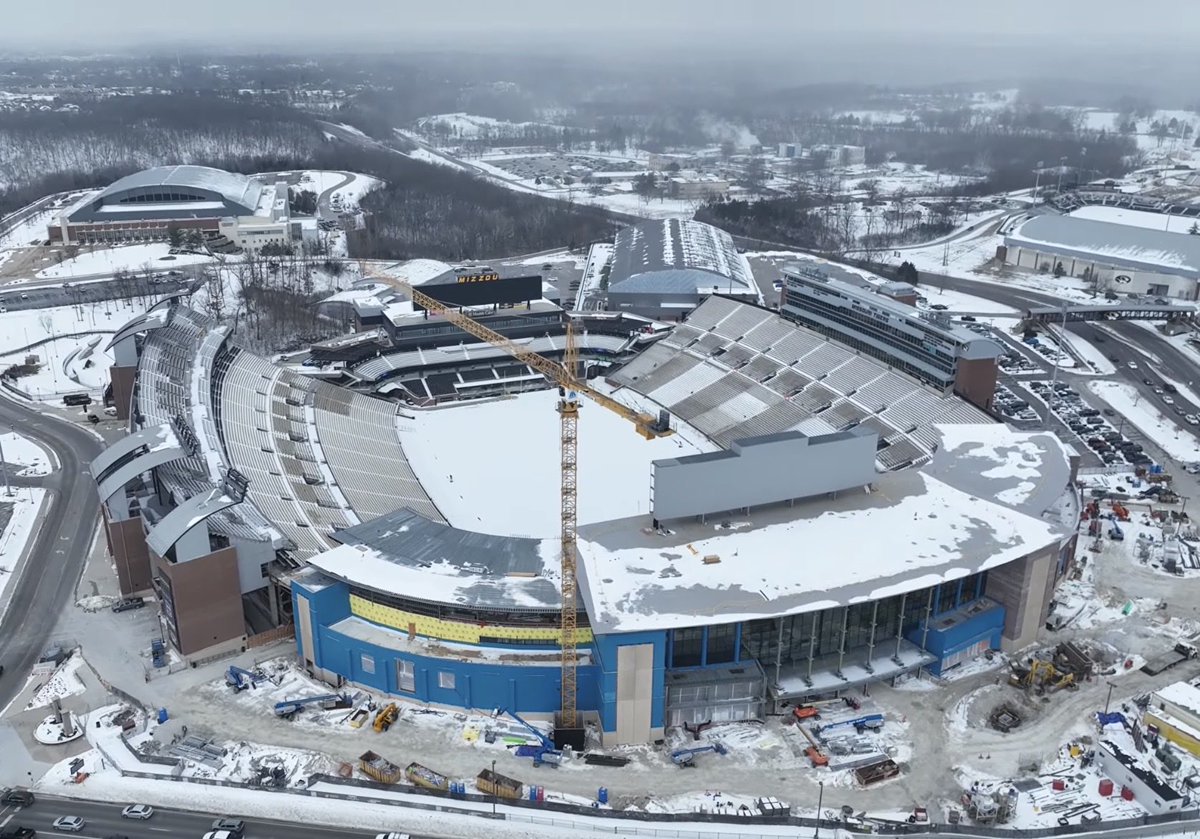

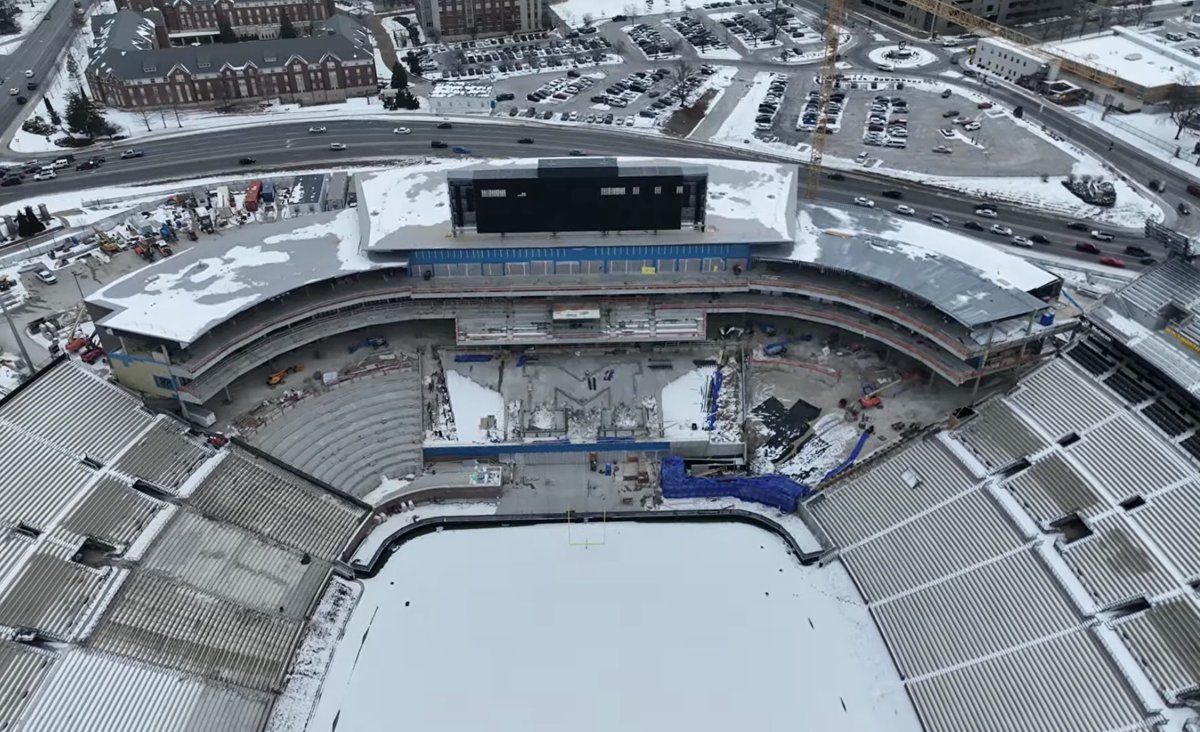

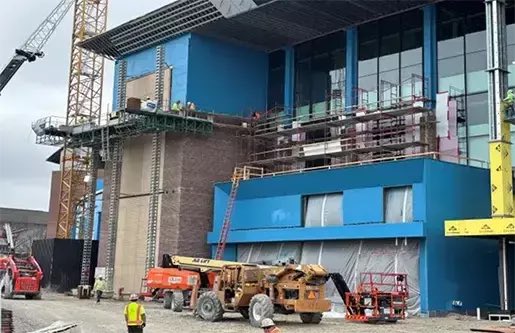

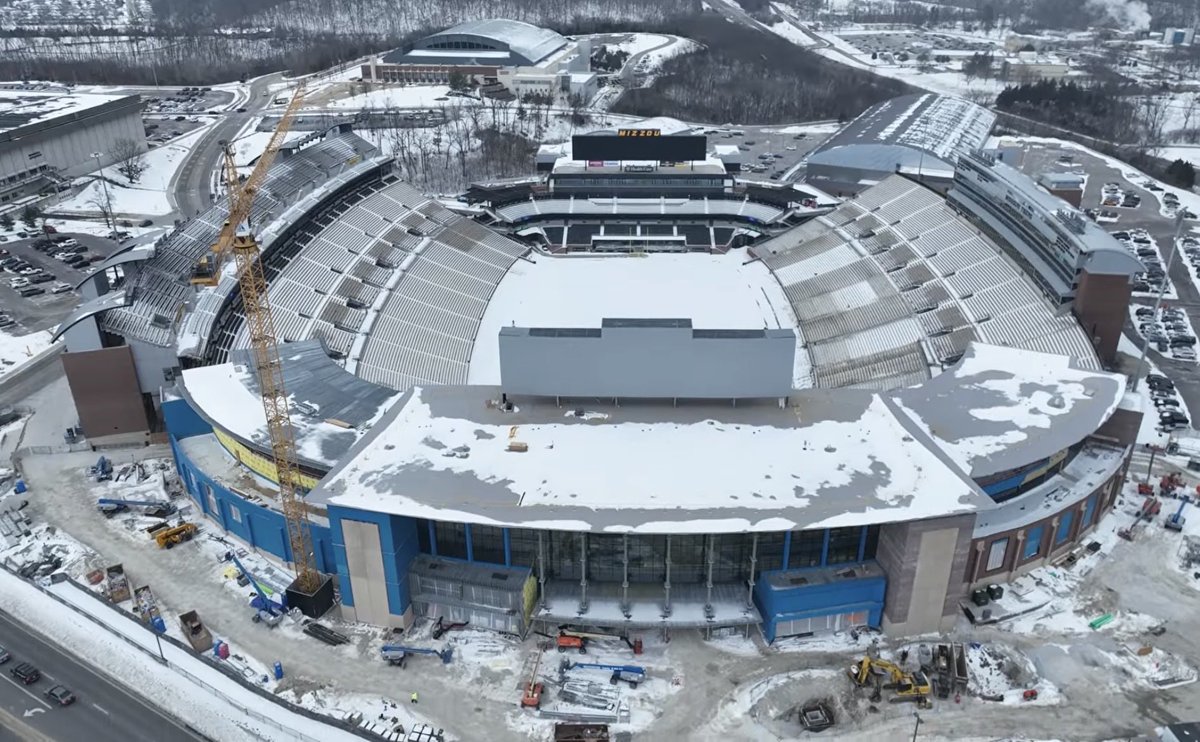

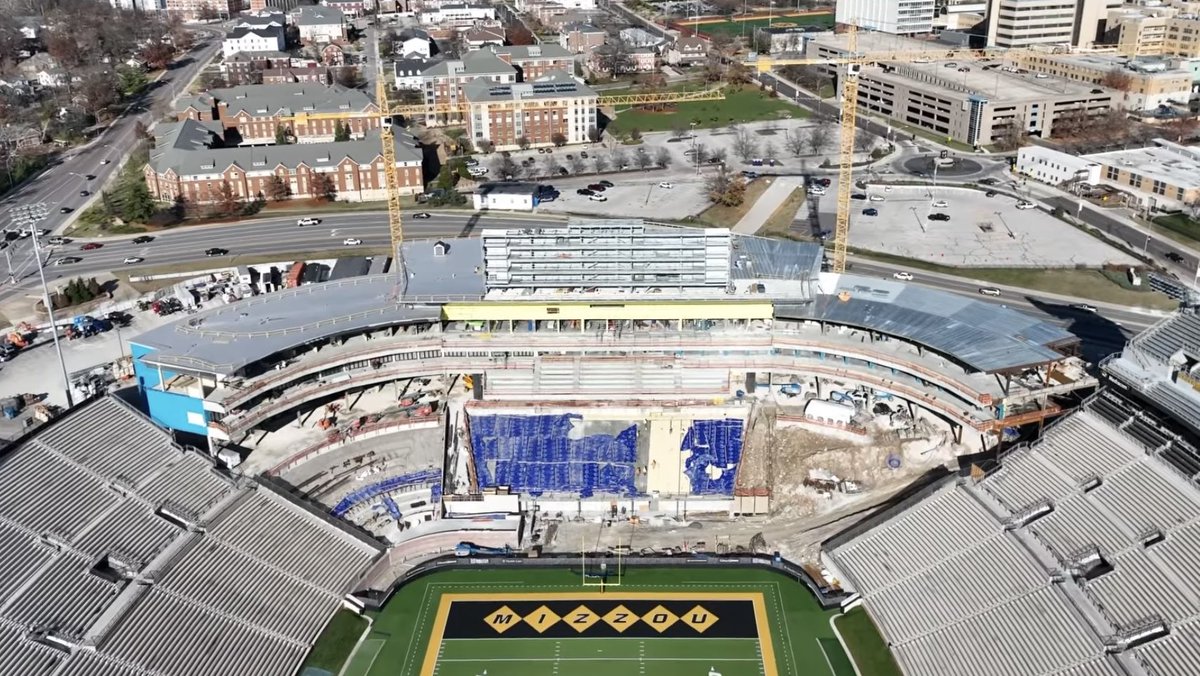

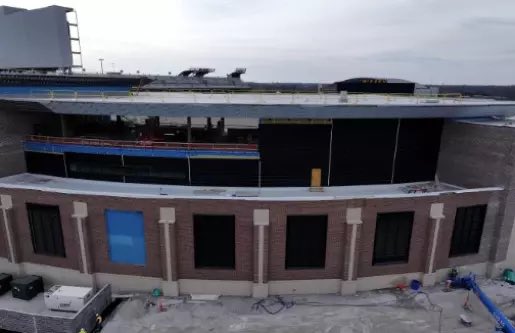

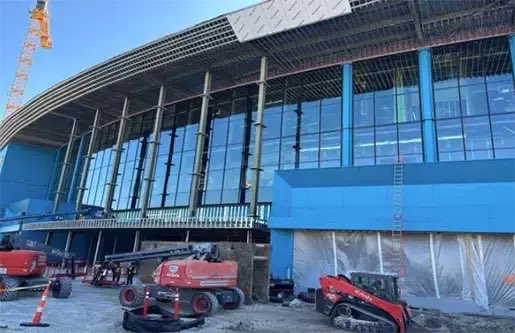

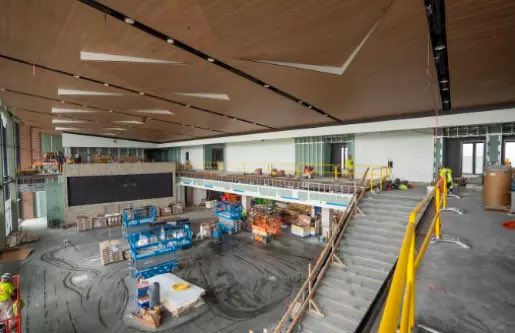

Week of 3/2/26

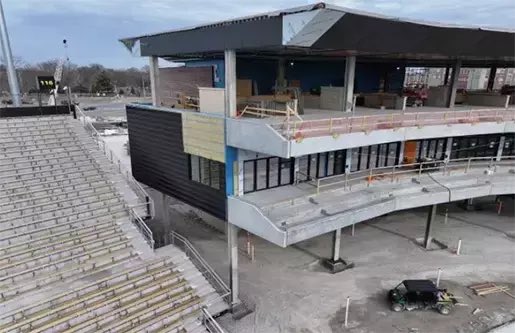

• Area B exterior columns framed out & receiving DensGlass/AVB
• Stair 3 is 75% complete with face brick
• East cast in place stadia made a couple of concrete pours

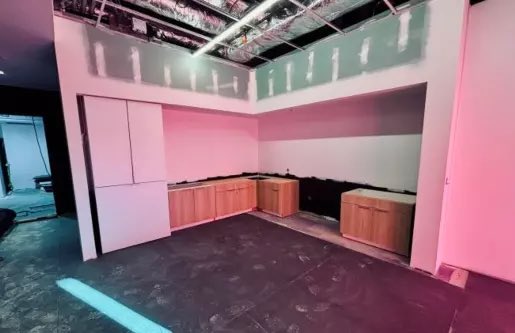

• Level 2 Kitchen equipment installed in main kitchen
• Field Level Loge CMU is 75% complete
Check out the view from our West Tiger Dens in the new North Endzone! 👀
MAF is currently holding Friday tours for those interested in seeing the new suites in person.
For more information, contact MAF or fill out the NEZ interest form in our bio! 🐯
As spring practice kicks off for @MizzouFootball, progress continues on the Memorial Stadium Centennial Project that will redefine the North End Zone experience for our fans and program.
Check out the latest construction updates & photos.
#MIZ 🐯
🔗mutigers.com/sports/2025/4/…
Week of 2/16/26
• Metal panels continue to go up on the west and north of Area A
• Underground storm drains are being installed
• Area C high roof is in progress

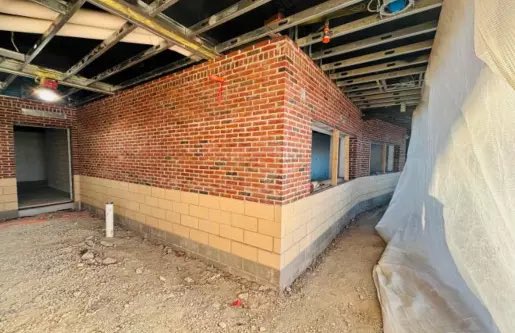

• Red brick has been installed on field level and field suite concrete masonry unit dividing walls are going up

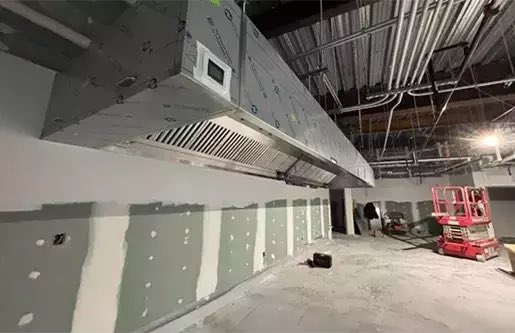

• Most West Level 2 suite tile are installed, bathroom wall construction begins next week
• Casework installation started, 5 Level 2 suites completed
Photos

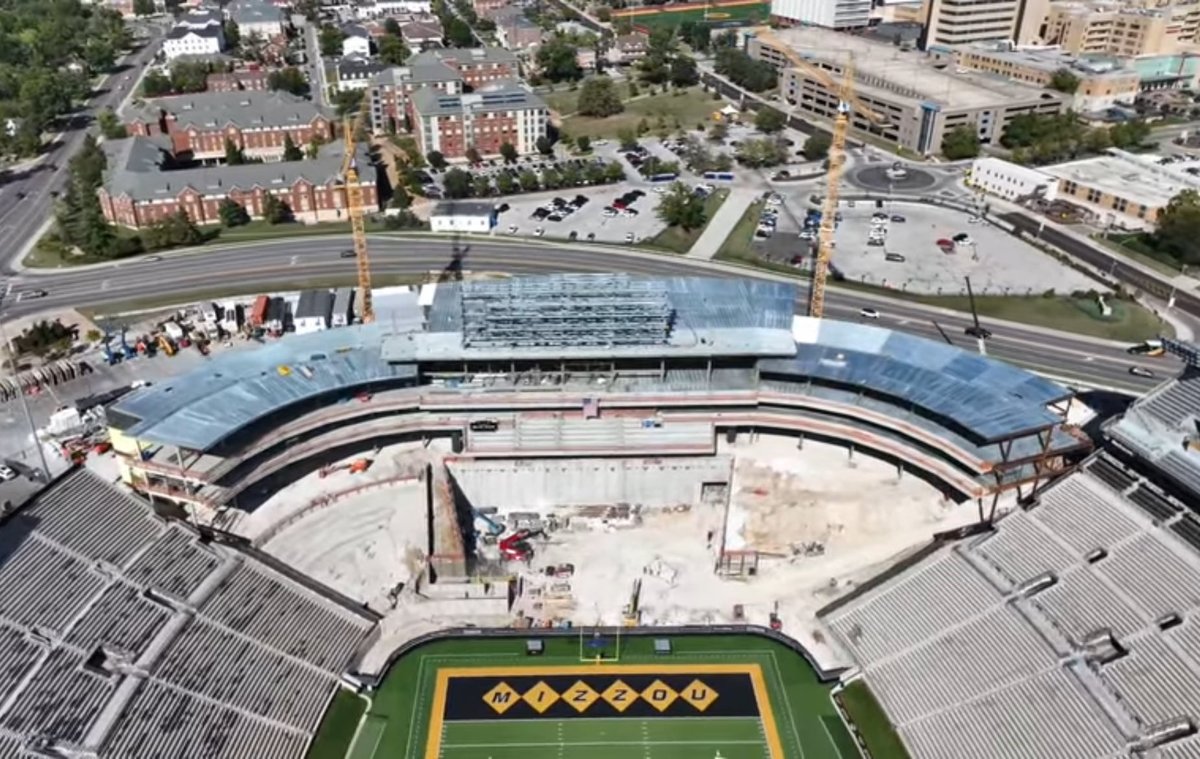

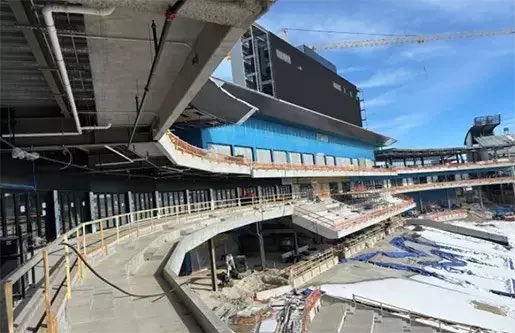

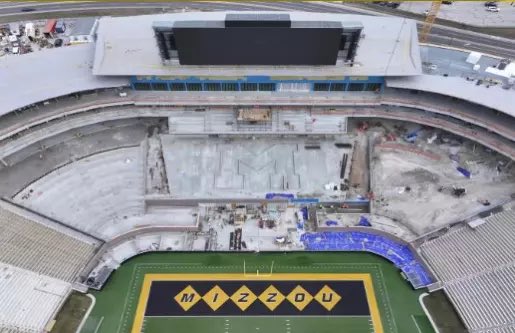

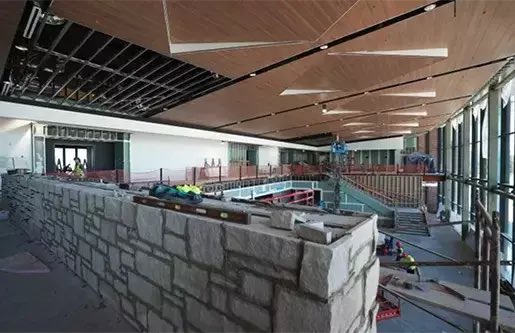

• View from South

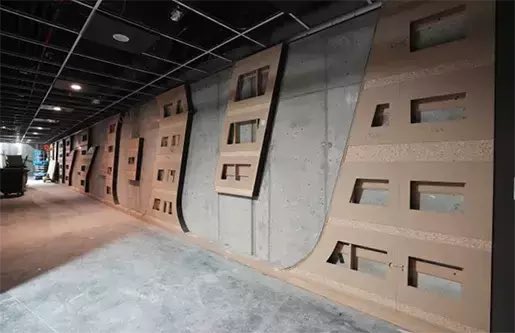

• Level C3 Knife Edge Framing
• Suite 27 Casework Install

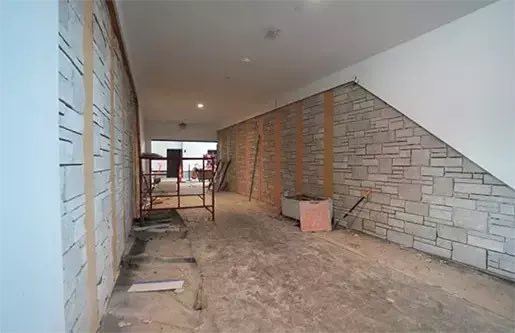

• Level 1A West Concessions Face Brick
Week of 2/2/26
• West concessions brick is complete & will transition to slab-on-grade installation later this month
• Level 1 East concessions block is on track to be completed next week.
• Roofing on the East 1.5 roof, targeted completion for Feb. 9.
• Rock M Club is getting drywall and will be complete in March.
Photos in order

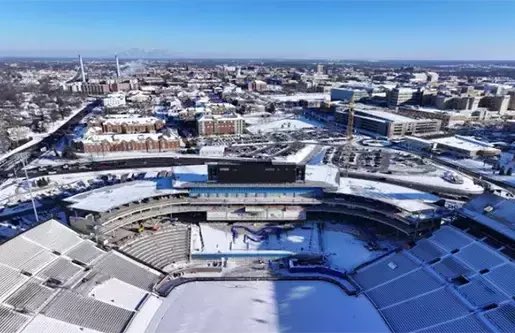

• View from North

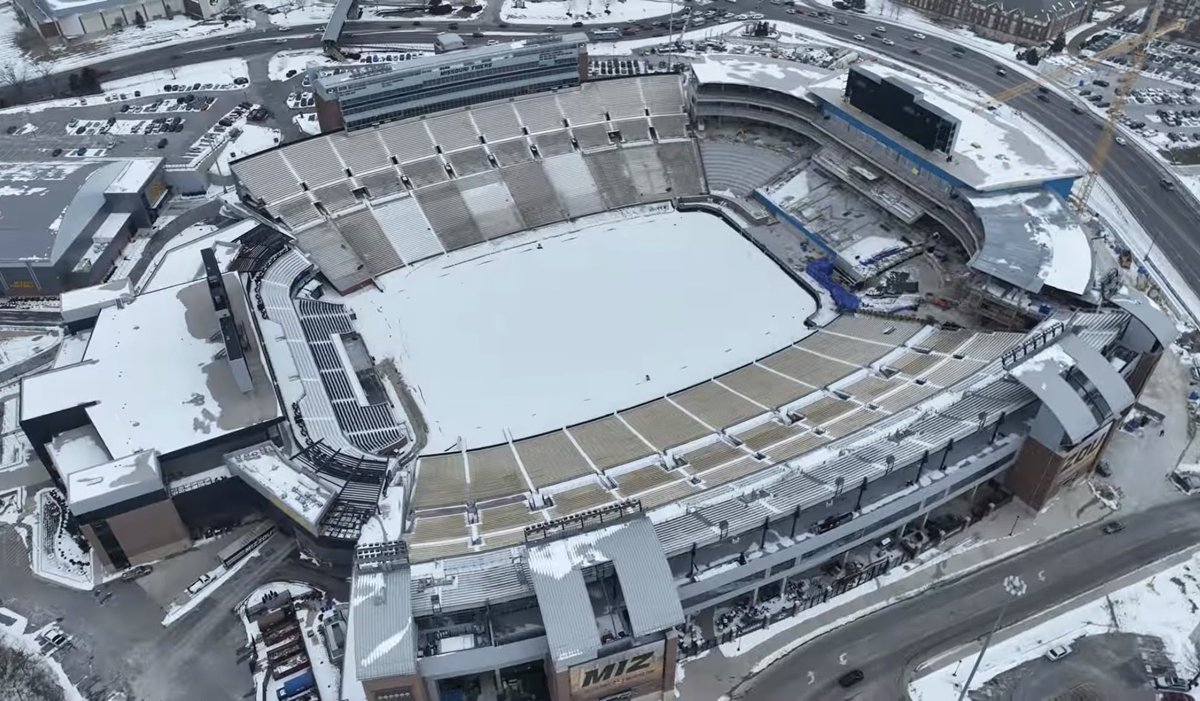

• View from South

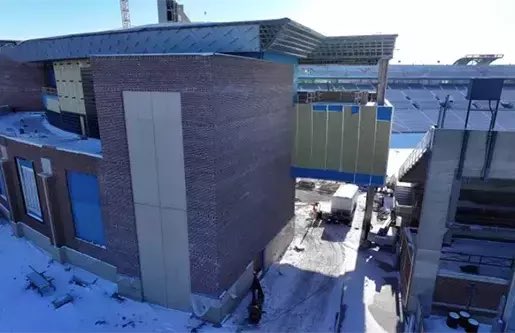

• Stair 1 Brick Elevation
• Level 2 & 3 Field Side
Week of 1/26/26
• Northeast precast completed & exterior Team Store framing cont.
• Cont. progress w/ west concourse masonry concessions decorative face brick, concourse slab on grade to follow in a few weeks
• Level 2A bathroom tile complete & the suites are next in line.
Week of 1/19/26
• Completed brick at Stair 1 & placed half of the east elevation precast
• Curb for the Rock M poured
• Drywall underway in Level 2 & Level 3 Areas B & C
• Area A suites receiving paint, ceiling grid & light fixtures & will be followed up with casework & tile
