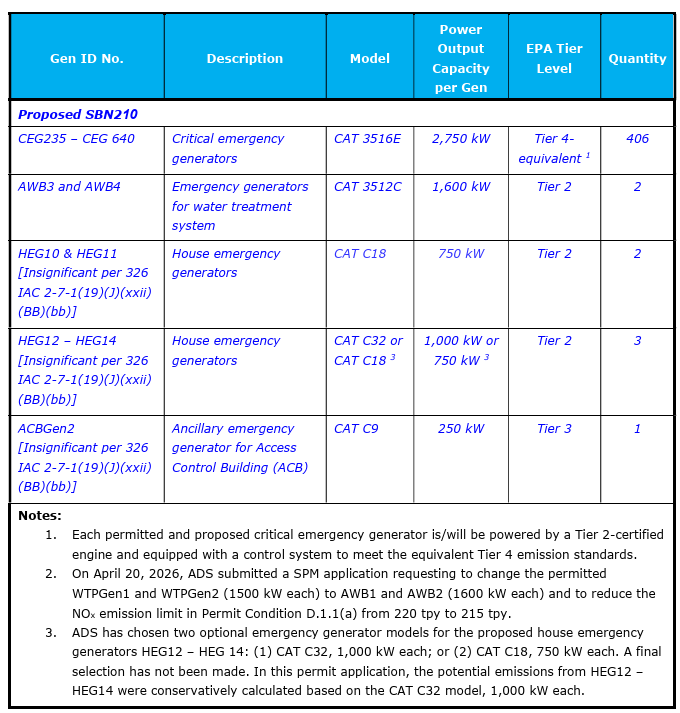

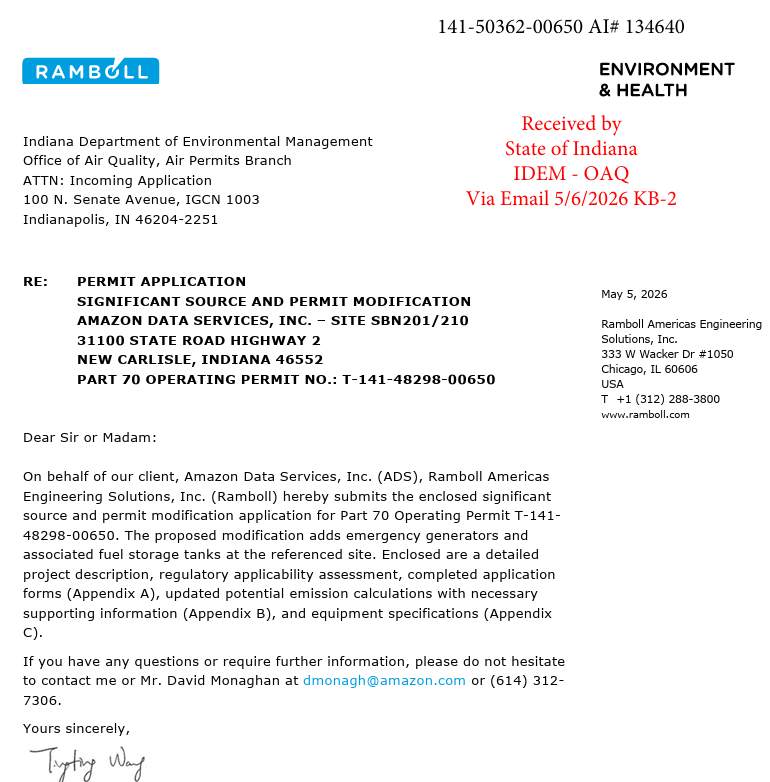

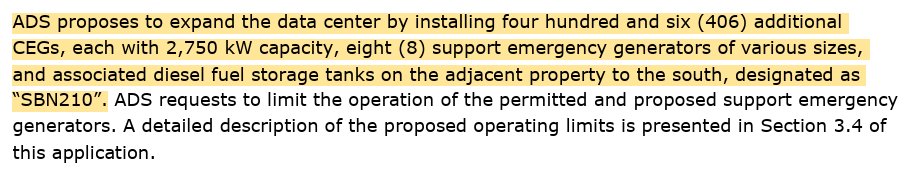

🚨SHOCKING🚨: Amazon proposes an extra 414 backup diesel generators at its New Carlisle, IN data center complex. This brings the total for Project Rainier to 909 backup diesel generators totaling >2,400 MW. It will store more than 6.1 million gallons of diesel fuel onsite.🤯
Ben Inskeep tweet mediaBen Inskeep tweet mediaBen Inskeep tweet media
Ben Inskeep@Ben_Inskeep

Amazon is asking permission to destroy 5 acres of wetlands and nearly 1 mile of streams as part of its resubmitted proposal to add 14 data center buildings at a third site at its sprawling New Carlisle, IN campus. Public comment is due June 12.

English
57
459
718
87K
