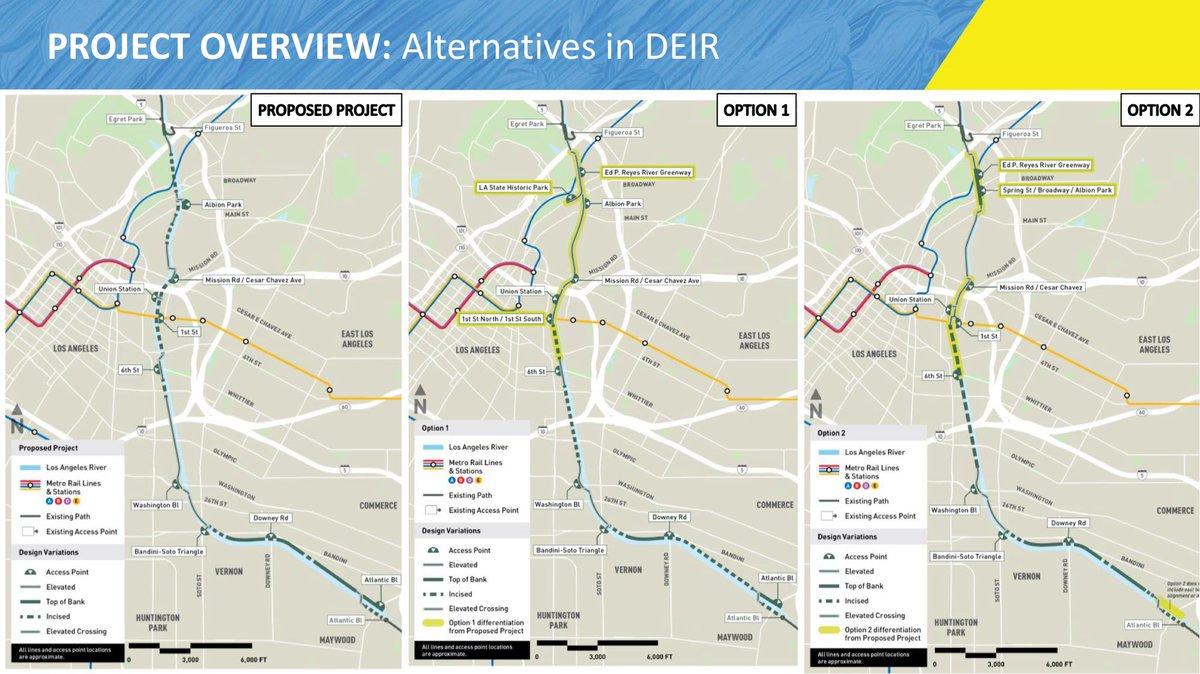

LA Metro announces community meetings in April for Sepulveda line ahead of Draft EIR release. They also launched a “hub” site with renderings and details of options being considered. stc-lametro.hub.arcgis.com

Vernon city staff recommend city council oppose LA Metro’s Link Union Station project. It removes Union Station freight storage, offset by Vernon expansions. Staff say it hurts businesses, increases pollution, traffic and emergency response times in city. cityofvernon.primegov.com/Portal/Meeting…

January 2024 Metrolink schedule on proposed schedule revamp. Proposed changes increases service, shifts from commuter-oriented schedule to providing service throughout day, with “pulsed” scheduling to have 4 times amount of transfer opportunities. metrolink.granicus.com/player/clip/10…

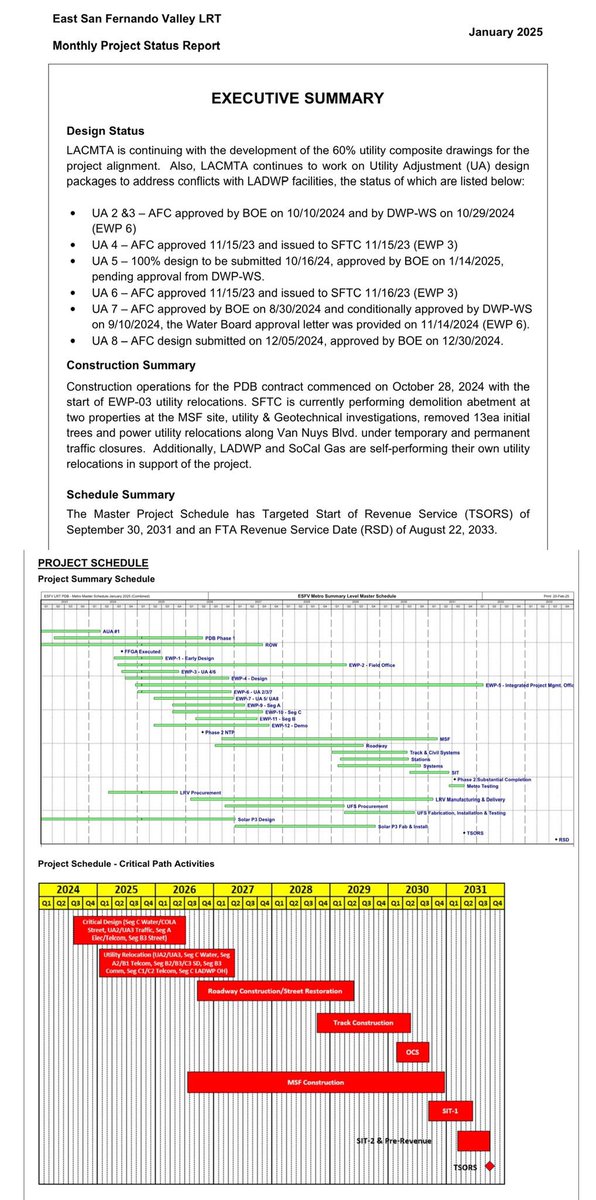

January 2025 status report for LA Metro’s East San Fernando Valley (ESFV) line. They finished negotiations and started work on 6 early work packages (out of 12 total). libraryarchives.metro.net/DPGTL/StatusRe…

Details from winning contractor’s bid for NoHo-Pasadena BRT construction contract. Estimated completion in early 2027, assuming work started in August 2024 (contract was not awarded until December). They propose building 6 segments simultaneously to complete things faster.

February 2025 update on LA Metro’s LA River path project. Draft EIR soon. Will be used by ~5,900 cyclists/pedestrians. Metro owns less than 1% of land, so they hope city/county will construct, operate and maintain project, with Metro providing funding. boardarchives.metro.net/BoardBox/2025/…

January 2025 status report for LA Metro’s D Line Extension Section 3. 59.3% as of 1/31/25, +1.5% since 12/27/24. libraryarchives.metro.net/DPGTL/StatusRe…

January 2025 status report for LA Metro’s D Line Extension Section 2. 76.7% as of 1/31/25, +0.5% since 12/27/24. No change in forecast completion this month (around early/mid November 2026). libraryarchives.metro.net/DPGTL/StatusRe…

January 2025 status report on LAX Automated People Mover. 91.7% as of 1/25/25, +0% since 12/28/25. Percentages are misleading (change orders distort progress). Contractor added 2 weeks to estimated service date (now 1/12/26 instead of 12/29/25). emma.msrb.org/P21897139-P214…

January 2025 status report for LA Metro’s D Line Extension Section 1. 96% as of 1/31/25, +0.3% since 12/27/24. Contractor added 30 days to forecast completion, now 11/8/25 instead of 10/9/25. libraryarchives.metro.net/DPGTL/StatusRe…

December 2024 status report for LA Metro’s East San Fernando Valley (ESFV) line. Utility adjustment package 6 is almost finished. libraryarchives.metro.net/DPGTL/StatusRe…

December 2024 status report for LA Metro’s D Line Extension Section 3. 57.7% as of 12/27/24, +0.6% since 11/29/24. Additional work (contract modifications) were added to contract, decreasing progress as percentage of contract value. libraryarchives.metro.net/DPGTL/StatusRe…

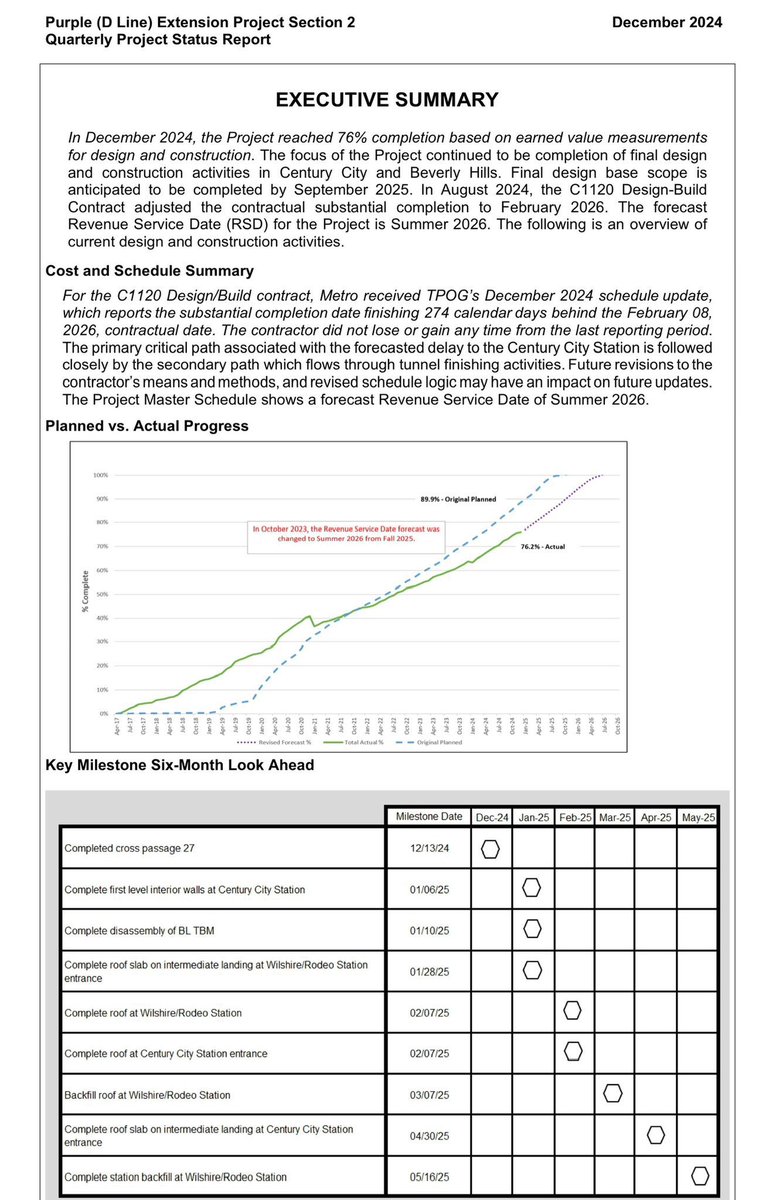

December 2024 status report for LA Metro’s D Line Extension Section 2. 76.2% as of 12/27/24, +0.5% since 11/23/24. No change in forecast completion this month (around early/mid November 2026). libraryarchives.metro.net/DPGTL/StatusRe…

December 2024 status report on LAX Automated People Mover. 91.7% as of 12/27/24, +5.2% since 11/23/24. Percentages are misleading (change orders distort progress). Contractor added 24 days to estimated service date (now 12/29/25 instead of 12/5/25). emma.msrb.org/P11817716-P113…
