Cheeeto

157 posts

Cheeeto

Cheeeto

@clockton

USA Katılım Temmuz 2008
1.1K Takip Edilen157 Takipçiler
Cheeeto
Cheeeto@clockton·
For Phase 1 (200 MW), the "adjacent generation" language means a planned direct interconnect to the Vistra/Constellation plants. But: - No PPA with Vistra or Calpine/Constellation has been publicly disclosed by either party - On the May 18 call, Charlie Nelson described the PPA as "progressing concurrently" and "likely to execute first" — meaning it is in negotiation but not signed - No ERCOT large-load interconnection application from NUAI/TCDC was found in public records — this was listed as a near-term milestone, meaning it likely hasn't been filed yet, or they don't need it?
English
1
0
2
446
Stock Enjoyer
Stock Enjoyer@samelifeenjoyer·
Following up on my $NUAI BTM colocation post. Did some digging into the PUCT docket and the regulatory picture just got significantly clearer. The final rules for net metering arrangements under PURA § 39.169 were adopted last month. The framework $NUAI would use is now fully in place. Turns out my post was not speculation but is concrete which is good news for all of us. Vistra filed comments in PUCT docket 58479, the exact rulemaking governing BTM colocation between existing generators and new large loads arguing specifically for a faster legacy track with a strict 180 day approval timeline. Companies don't spend legal resources on proceedings that don't affect their active business plans. There's already a live Texas precedent. CyrusOne filed a BTM colocation application with Calpine for a 760 MW data center in Freestone County under the exact same framework. Fossil gas generator plus large data center load. Same structure $NUAI would use. This is directly relevant to $NUAI's TCDC project. Calpine operates Quail Run directly adjacent to TCDC on the investor map. Vistra operates Odessa Ector Power Partners also directly adjacent. $NUAI has two active BTM colocation counterparties sitting on their fence line and at least one of them just proved the model works in Texas. The 54 acre corridor connects TCDC directly to them. Yes, $NUAI would need a tie-in-station on their 54 acres of land. I do not want to oversimplify these engineering milestones but between Charlie, Will, HS selected engineering partner - Ramboll, and Stream I would suspect they are ahead of the curve on this. One more thing worth addressing directly since I know someone will bring it up. No, Vistra/TCDC net metering application has been filed at PUCT yet. Just because there is not a public filing does not mean it is not in the works. Again, reminding us Charlie hinted at "one big signing day". Here's why I am not currently concerned: I pulled every active § 39.169 net metering application currently on file in Texas. There are five of them, see attached photo which highlights these documents. Every single one lists both the generator AND the large load customer as joint applicants. Freestone Power Generation filed with C1 Freestone 1 LLC. Crusoe filed with Ensign Infrastructure. The generator and the confirmed load file together. The Vistra Comanche Peak docket 59399 detail proves Vistra specifically knows how to file these applications and has done it already. $NUAI hasn't announced a hyperscaler lease yet. That's the known missing piece, not the power solution. You don't file a net metering application without a confirmed load customer because ERCOT studies the specific load characteristics of the facility being co-located. Filing before the lease would be premature and put the cart before the horse. If you would like to search around the PUCT site. See the link below. Maybe you will find something I did not! I found this to be directly relevant for all invested or looking to invest in $NUAI and figured a post here would be appropriate. interchange.puc.texas.gov
Stock Enjoyer tweet media
English
10
4
64
6.2K
Cheeeto
Cheeeto@clockton·

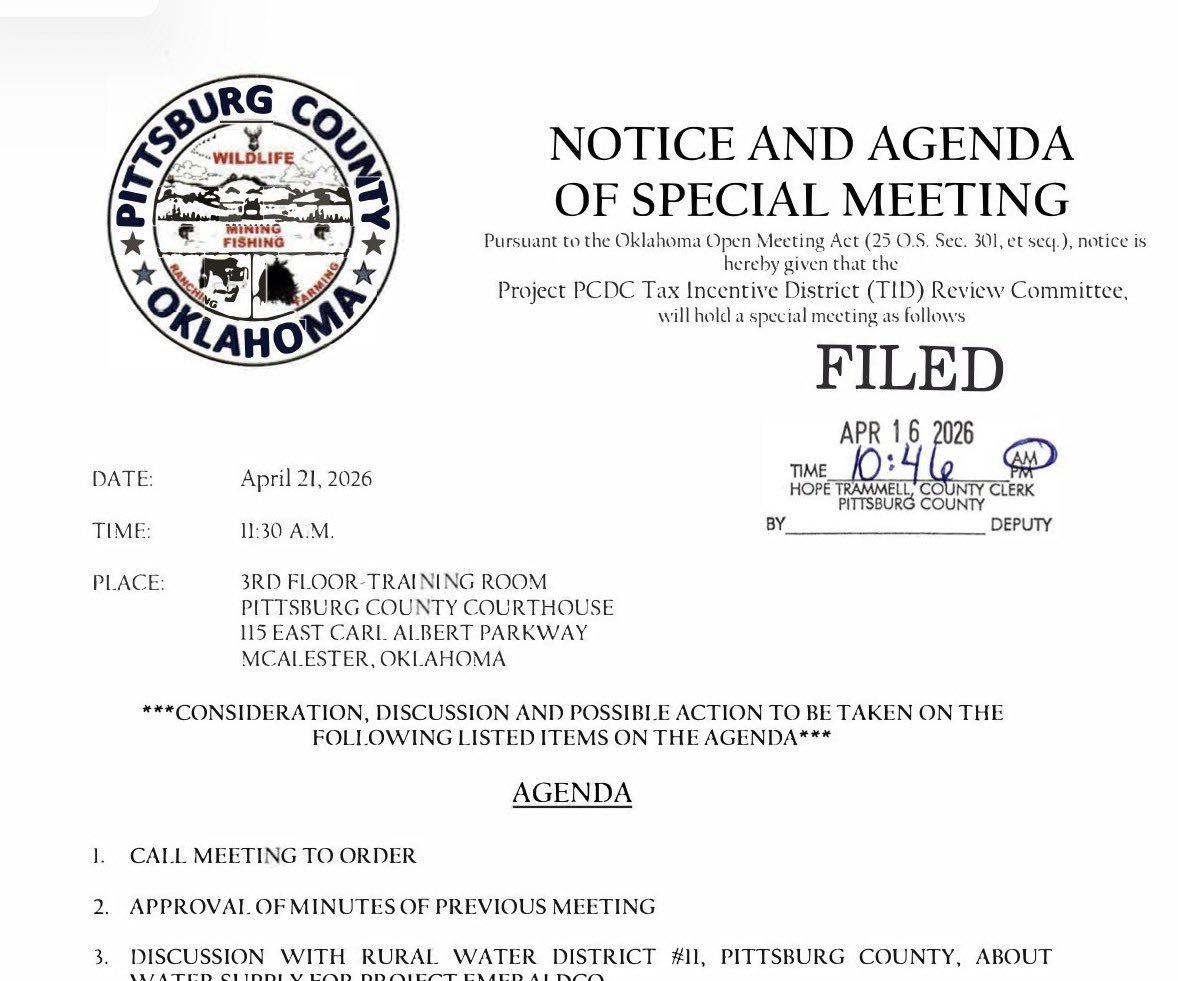

The Water Supply: Rural Water District #11 Cooling a 1.6 GW AI data center requires an amount of water, making local utility securement just as critical as power. You were spot-on regarding the infrastructure hurdles. The official agenda for the April 21, 2026 meeting literally contains this line as Item #3: "DISCUSSION WITH RURAL WATER DISTRICT #11, PITTSBURG COUNTY, ABOUT WATER SUPPLY FOR PROJECT EMERALDCO."
English
0
0
2
667
DNV999
DNV999@DNV99999·
$IREN And OKLAHOMA is also Fully APPROVED.
DNV999 tweet media
English
11
38
418
27.5K
Cheeeto
Cheeeto@clockton·
The Water Supply: Rural Water District #11 Cooling a 1.6 GW AI data center requires an amount of water, making local utility securement just as critical as power. You were spot-on regarding the infrastructure hurdles. The official agenda for the April 21, 2026 meeting literally contains this line as Item #3: "DISCUSSION WITH RURAL WATER DISTRICT #11, PITTSBURG COUNTY, ABOUT WATER SUPPLY FOR PROJECT EMERALDCO."
English
1
0
1
691
investing
investing@DollarCostAvg·
$IREN has another 1.6 GW approval for its Oklahoma Site and now proceeding with the next steps. $IREN is undoubtedly Programmed to become a hyperscaler in its own right.
investing tweet mediainvesting tweet media
English
6
65
627
33.4K
ChinoAleman
ChinoAleman@chinoalemano·

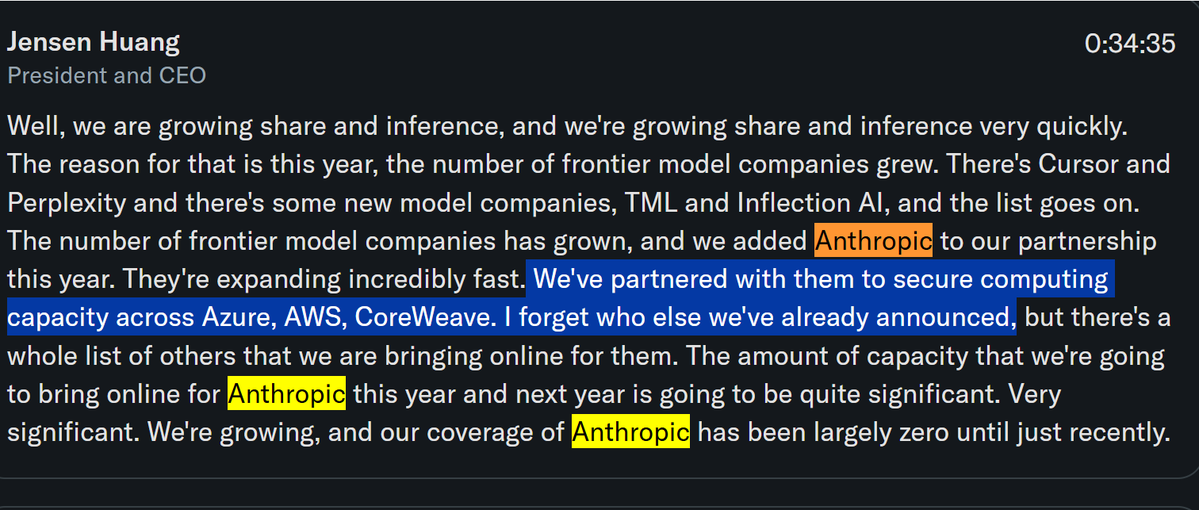

$IREN - I called it. It's happening. I'm not responsible for what people understand. I'm responsible for what I say. And what I said has come true. My thesis, like I said, was simple: $NVDA already had a client lined up before going to IREN. Turns out, it was Anthropic. Like I said, NVIDIA would surface a deal with Anthropic. When I said no BS, this is what I was talking about. Funny how now everyone "knew.". Funny how now it was "obvious.". I called it. With real money behind it. Under $48. With a lot of IRE (2x IREN). With my name behind it. Before it happened. The headline of my post was "a deal involving IREN", in the comments below I clarified (if it wasn't already clear from how I phrased it) that it's more likely to involve IREN than to mention IREN by name. And sure enough, Jensen avoided mentioning IREN. How is he not going to remember that right before the call he was talking to @danroberts0101? How is he not going to remember Dan, when one of the guys asking him questions was literally named Dan? He doesn't remember? He can't say it? He doesn't want to say it? Also, in another post, I mentioned that obviously it wouldn't be limited to IREN, it would involve NBIS and CRWV too. I want it noted that when I said these things: ➙ There were no posts from Dan Roberts saying something would happen. ➙ There were no posts from IREN with "Day 1." ➙ There were no posts from @mikealfred. All of that came after. When I made these claims, it wasn't obvious at all. People said: "NVIDIA isn't going to announce anything, just revenues." They also said: "Anthropic already did a deal with SpaceX." And yet, loud and clear yesterday, Jensen said: "We've deepened our relationship with Anthropic and we're going to get them compute." And obviously, it includes IREN. We've got IREN syncing their marketing with NVIDIA's. Whether they want to make it official now or just build hype, that's another story. Right before NVIDIA's earnings call, Dan shows up on Fox Business. Now they're both over at Dell. And IREN just said something "pretty" big coming to the sphere. It's clear this is a coordinated campaign. Maybe IREN trying to coordinate with NVIDIA, but it's coordinated. Now IREN is hyping things up. Saying something pretty big is coming. The show has just begun. 🍿 Din. Dan. Dell.
ChinoAleman tweet media
English
32
12
263
65.4K
Cheeeto
Cheeeto@clockton·

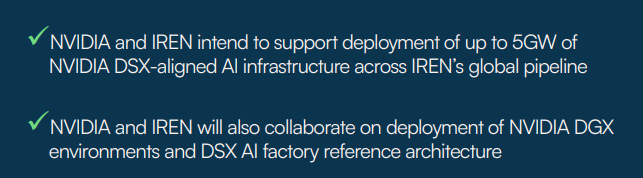

That wording differs from the press release; specifically, the second bullet is material: NVDA press release: "...collaborate on deployment of NVIDIA accelerated compute in DSX AI factories to expand access to AI-native, startup and enterprise customers." • IREN deck: "...collaborate on deployment of NVIDIA DGX environments and DSX AI factory reference architecture." • Delta: The press release framed bullet 2 around customer access (who gets served — AI-natives/startups/enterprises). The IREN deck reframes bullet 2 around what is actually being built — DGX environments + DSX AI factory reference architecture.
English
2
0
1
254
Frans Bakker
Frans Bakker@FransBakker9812·
$IREN Weekly Space 5/10/2026 Join me for another weekly space at 9PM ET. The "earnings aftermath". I will discuss various topics from the earnings, and review the earnings call. RSVP below. Welcome guest speakers! x.com/i/spaces/1qJVm…
English
17
17
133
12.8K
Alexander
Alexander@AlexfromBabylon·
$IREN Great reply from @FransBakker9812 with the bull perspective. Mutiple perspectives are always valuable to form your own opinion. That said I still cannot shake the feeling that they oversold themselves for 2026. Maybe that is also a communication problem from the company. Missing so hard on delayed GPU could have been prevented via more accurate guidance or follow-up communication. That’s what I mean with new to operate at such a large scale. Why they discovered this problem today and not 6 months ago? The truth is probably in the middle. I guess that hits me harder because my holding period was not 5-10 years, but 1-3 years.
Frans Bakker@FransBakker9812

“The most important is the narrative violation on time to compute.” This is your choice to make the most important, the sentence in itself is predetermined, not objective on both counts. “It turns out that if you don’t have a lot of experience running a large scale cloud you run into delays. IREN is amazing in constructing the powered shell, but clearly has more difficulty in bringing GPU’s online. Hence the delays. Also because they rely on third party server installs from Dell & co.” Running a large scale cloud is happening after the GPUs are installed and commissioned, a “large scale cloud” implies coherent working GPUs connected by infiniband or similar, delays don’t happen ahead of running a large scale cloud while commissioning GPUs, but during the process of receiving them from an OEM that is chip constraint. You conclude that experience in running was because of the difficulty of bringing GPUs online “hence the delays”. This completely acknowledges, and literally omits the delivery delays from Dell. But you do want to blame Dell to emphasize “server installs”, I wonder why the servers are being included here, server installs are the absolute easiest part of the job. But I know the answer, and you bring it forward soon enough (hint: Nebius). “Next the power narrative requires a reset with moving SW completely to 2027. Smart move to get VR’s, but a violation of the power now narrative. For me its quite clear that they cannot bring the capacity online fast enough to let this be a heavy advantage versus other neoclouds.” You front load your take with a conclusion that you do not deserve to draw. First of all, the “time to compute” narrative does not mean the fastest time to install any chip. It is the fastest time to the highest possible token/MW within a certain window of time that matches customer demand within that window. Let’s turn this take around, if $IREN could have stood capacity up sooner, and would have data centers ready now in Sweetwater, this would have been a 2025 deal with 2025 economics, and for GB300s. As you know, the 2025 economics weren’t great (well you pretend not to know because you believe Nebius got a great deal without knowing the unit economics), and the GB300 isn’t a very efficient product on a token/MW basis. What IREN instead did, was build out the high voltage step-down infrastructure to the tune of 750MW worth of primary substations and a bulk substation all tier III redundant, and now have a blank canvas to sell 2027 VR200 capacity with guaranteed chip delivery from Nividia. Would IREN have opted for GB300 and a 2025 “backlog” for 2026, we would all be crying now because the deal economics would probably not be much better than the $MSFT deal. So instead of being an early mover that goes deep to bring current generation compute online, they chose to go wide instead, and can bring multiples more of next generation compute online a year later. I think you have to realize that this was not a lack of ”ability bringing capacity online fast enough”, but a strategic decision to maximize the token/MW out of their flagship site, by conceding a slower ramp up in initial compute, but catching up by a “go wide” strategy with VR200s into 2027. You can call it what you want, but it certainly is not a shortfall in the "ability to bring capacity online". If you want to quantify “speed of bringing capacity online” you cannot dismiss a strategy that was opted to promote the tokens/MW and the $/MW output, albeit later. Time to compute is not a static slogan that you can apply to fit your narrative. Time to compute is a flexible concept that does not mean a race to indiscriminately bring as much single chips online from now until the end of the site’s capacity. Therefore, there is no “violation” of “power now”. Because that was never a thing in the first place. “Finally it is also clear that even if you design your datacenters for HPC, the organization was not. The Mirantis deal was really neccesary to bring in mature cloud experience and enterprise sales support” “The organization was not ready for HPC” Here you go again steamrolling over the fact that there is a wide variety in what you can label as HPC. IREN has been running their AI cloud for almost 2 years, be it in a very small GPU quantity. The organization has been slowly adapting to this over the course of the last 2 years, and prior to Mirantis, IREN was able to contract Microsoft, contract $500m of AI ARR, and grow their AI revenue from <$1M per Q to $33.6m per Q. IREN has always been ready for AI cloud, which is a form of HPC, you need to call the activity what it is, and using a general term like HPC is purposely misleading because it gives the idea that there is only Bitcoin mining, and HPC. Mature cloud experience, Enterprise sales support, are all words that fit Nebius very well, and yes Mirantis will certainly bring that experience to IREN as well. But nothing from the earnings call screams that IREN needed Mirantis to run AI cloud, let alone HPC. IREN has acquired Mirantis to complement their AI cloud offerings, and connect to a growing TAM of enterprise customers and tap into the sovereign market. Just because IREN decided to do this now, doesn’t mean that everything they did prior to the acquisition should be dismissed as “not ready for HPC”. That’s just disingenuous from you. Finally you say this: “but the execution premium in the valuation versus Nebius for me makes more sense now” This implies that IREN has no execution premium? What exactly has Nebius actually delivered? I agree with you that the valuation of Nebius is rich, and IREN is certainly being discounted. But the bulk of the valuation disparity is because Nebius has agreed to sign more deals for 2027 and beyond. Where IREN has not signed anything for 2027, outside of a 3.4B deal with Nvidia for early 2027. So is Nebius getting an execution premium, or are they just being rewarded for a higher RPO and backlog? You have applied a lot of bias in your take. I have taken the time to give you a rebuttal that carries my personal view on IREN. I really don’t understand how you could ever be in my subscriber group, and still have such bad takes man. It’s a waste of time to try and bring this type of material out there, because you honestly have no idea what you’re talking about. I have talked to IR at IREN and the delays were for the most part due to the GPUs being delayed. ‼️‼️ Why don’t you compliment IREN on their partnership with Nvidia where they get on par with Nebius in GPU priority? This literally solves the issue that you have wrongfully described in your post. If I can give you some advice, try to be a bit more objective next time, and consider that there are many reasons why revenue can be delayed, and by the same token, why deals can be signed later.

English
3
0
29
14.6K
Cheeeto
Cheeeto@clockton·
Data shows clear hiring acceleration into April: active postings rose from 16 in January to 28 in February, 37 in March, and 48 in April. The biggest recent signal is Sweetwater, where 9 of 16 active roles were posted in April, including 6 in the final week — mostly HV/electrical, mechanical construction, maintenance, operations, and site-readiness roles. Childress looks more mature and operational, with 27 active postings across data-center technicians, operations leads, HVAC maintenance, LOTO electrical/mechanical, network/security, warehouse, facilities, and construction support. Sweetwater looks earlier but is accelerating fast, with a job mix that suggests movement from heavy construction toward commissioning and operations readiness. Overall, the hiring pattern is directionally bullish. IREN appears to be spending against real physical execution, with Childress already looking operationally mature and Sweetwater showing a sharp late-April ramp.
English
0
0
1
185
XCap
XCap@XCapitalMgmt·
The two most verifiable signals for $IREN are (i) job postings, & (ii) construction progress. Both are real $ going out the door w/ lead time - only way to justify is w/ deals. Been disappointed to-date this year w/ % of hires going to Sweetwater - glad to see that ramping up.
XCap tweet media
English
10
15
170
16.5K
Cheeeto
Cheeeto@clockton·
really interesting framework. How solid do you think the $3.50/hr number is for B300s at Childress, and what kind of customer do you see paying that? Also curious how much of the 400 MW you think IREN can realistically finance and bring online without getting too ugly on dilution or bridge capital.Really
English
1
0
5
1K
₿itcoin ₿utcher 🥩 🐑 🐷
₿itcoin ₿utcher 🥩 🐑 🐷@bitcoinbutcher1·
$iren B300 Childress huge upside @DollarCostAvg asked me what the remaining 400 MW at Childress would cost $iren in investment along with the ARR ramifications. In summary, @danroberts0101 can buy 136k GPUs and retrofit 400 MW gross for air cooled B300 and generate $4.2B ARR with a payback period of the GPU and retrofit costs in just over 2 years before debt service. This $4.2B is only 8.9% of the reported secured power and exceeds the current guidance of $3.7B by more than double. Notice how this excludes SW1,2 OK and Australia Here’s napkin math detail 👇 1) 17000*8=136,000 GPUs Additional GPUs to fill Childress; @jiahanjimliu @_Sgr_A_Star have posts related to the power draw. 2) 136000*3.50*365*24= $4,169,760,000 ARR ARR calculated using a contracted rate of $3.50 per hour and assumes 100% utilization by the enterprise for the exclusive right to use. B200 are currently trading at $6 in spot markets due to compute shortage 3) 136000*70000= $9,520,000,000 B300 cost 70k per GPU announced $3.5B / 50k GPUs from latest press release 4) 400/1.3*3500000= $1,076,923,076.92 Retrofit cost Assumes $3.5m/MW for redundancy and liquid cooled racks or RDHx 5) 1.077+9.52= $10.597B total cost There will be interest expense but let’s keep this high level for now. 6) 10.597/4.170*.85= 2.16 year payback Uses 85% EBITDA margin as proxy for cash generation. Again debt service cost excluded for simplicity
English
21
20
185
35K
𝐀𝐠𝐫𝐢𝐩𝐩𝐚 𝐈𝐧𝐯𝐞𝐬𝐭𝐦𝐞𝐧𝐭𝐬
$IREN: Fake vs Real Power Something that appears to be overlooked by the broader $IREN investor community, and especially by analysts, is the recent set of ERCOT (Texas grid) changes. For a long time, most data center developers could purchase random parcels of land, or secure land through option agreements, and then claim they had a “multi-GW” power pipeline in Texas. Somewhere in the footnotes, they would then clarify: *Pending grid studies, interconnection agreements, and ERCOT approvals.* It used to be difficult to distinguish between what was “real” power and what was, at best, aspirational. That was especially true for projects already halfway through the process, such as those that had partially completed grid studies but had not yet secured the remaining approvals. This led to a tsunami of “fake” power claims from operators across the industry, many of whom used inflated pipeline claims to support their valuation and strengthen their negotiating position. With the new ERCOT changes in place, that is no longer possible. The statewide grid operator has now introduced a new batching system that categorizes projects based on real, tangible progress and the steps they have taken, queuing them accordingly. As of today, it largely comes down to whether your project is in “batch 0, base load”. If you are not in this initial batch, you can effectively kiss your project goodbye until, at the very earliest, 2028. For the first time, counterparties (i.e., customers) and investors alike can distinguish between what is real and what is fake, or at best still many years away. This plays directly into $IREN's hands, as it is one of the few operators in the space that has always been straightforward about its power pipeline, only announcing sites that have gone through all the necessary steps and approval requirements. As such, $IREN's Sweetwater 1 & 2 sites are all but guaranteed to be in the first “base” batch, with additional unannounced sites also likely to be part of it. These new changes undoubtedly strengthen $IREN's negotiating position, as the pool of seemingly near term capacity has now shrunk by a meaningful margin.
English
37
41
429
59.2K
Christian Ruf
Christian Ruf@pinpulleddrmf·
Fighting the urge to sell all my grills and go back to a big green egg. It’s the .30-06 of grills.
English
77
3
196
28.1K
BitcoinAIGuy
BitcoinAIGuy@BitcoinAIGuy·
just gonna leave this here $IREN hope this helps
BitcoinAIGuy tweet media
English
63
69
654
74.7K
Jordan
Jordan@HyperAICapital·
🚨 BREAKING: INSTITUTIONS SLASH $IREN SHARES BY OVER 60% Stratos Wealth Advisors reduced its position to 26,600 shares, a 63% decrease. CloudAlpha Capital Management cut its stake to 66,268 shares, a 68% reduction. Latest filings show notable institutional trimming.
Jordan tweet media
English
92
9
205
130.5K
Lian Lim | Dashboard & AI Automation Expert
here are 4 ways to make money with OpenClaw (Clawbot) i just created a playbook breaking down each one: 1. Setup-as-a-Service 2. AI Assistant-in-a-Box 3. Proactive Monitoring & Alerts Subscription 4. Skills, Education & Micro-SaaS this is how you turn one self-hosting tool into multiple income streams want the full playbook for FREE? Comment "OPENCLAW" and i'll DM it to you (must be following)
Lian Lim | Dashboard & AI Automation Expert tweet media
English
931
97
907
93.9K
Cheeeto
Cheeeto@clockton·
@danielisdizzy And is it capable of supporting the 2.5 kW Rubin which are around the corner
English
0
0
0
206
Daniel
Daniel@danielisdizzy·
One of the most discussed numbers from $NBIS earnings is the 3 GW of secured capacity expected by the end of 2026. The rapid growth in contracted power can make it seem straightforward — and make $IREN secured power advantage seem less like a real moat. But the nuance matters. Much of $NBIS capacity comes from leases and reallocating existing infrastructure to AI data centers. That’s different from bringing entirely new energy supply online, as in $IREN case. Not all secured capacity is created equal.
Daniel tweet media
English
10
5
64
12.5K
Cheeeto
Cheeeto@clockton·
With the four hyperscalers now having reported, the next 12 months look like an AI infrastructure regime, not a cycle: • Alphabet up 100%+ to ~$180B • Meta up ~80% to ~$125B • Amazon up 50%+ to ~$200B • Microsoft up ~35% to ~$135B That’s over $600B of CapEx from four companies in a single year.
English
0
0
0
26
